CivilRisk IQ — Put risk in its place
Menu

Put risk in its place.

See project risk
before it becomes
project cost.

CivilRisk IQ reviews plans, technical reports, environmental documents and Caltrans submittals with a team of 21 AI specialists. An accountable engineer or decision-maker then verifies what matters, so every finding is tied to its source and ready for a decision.

See a real finding

State highway and local projects · Typical review in 5–10 business days

CRIQ review · I-215 / Keller Interchange · sheet D-7

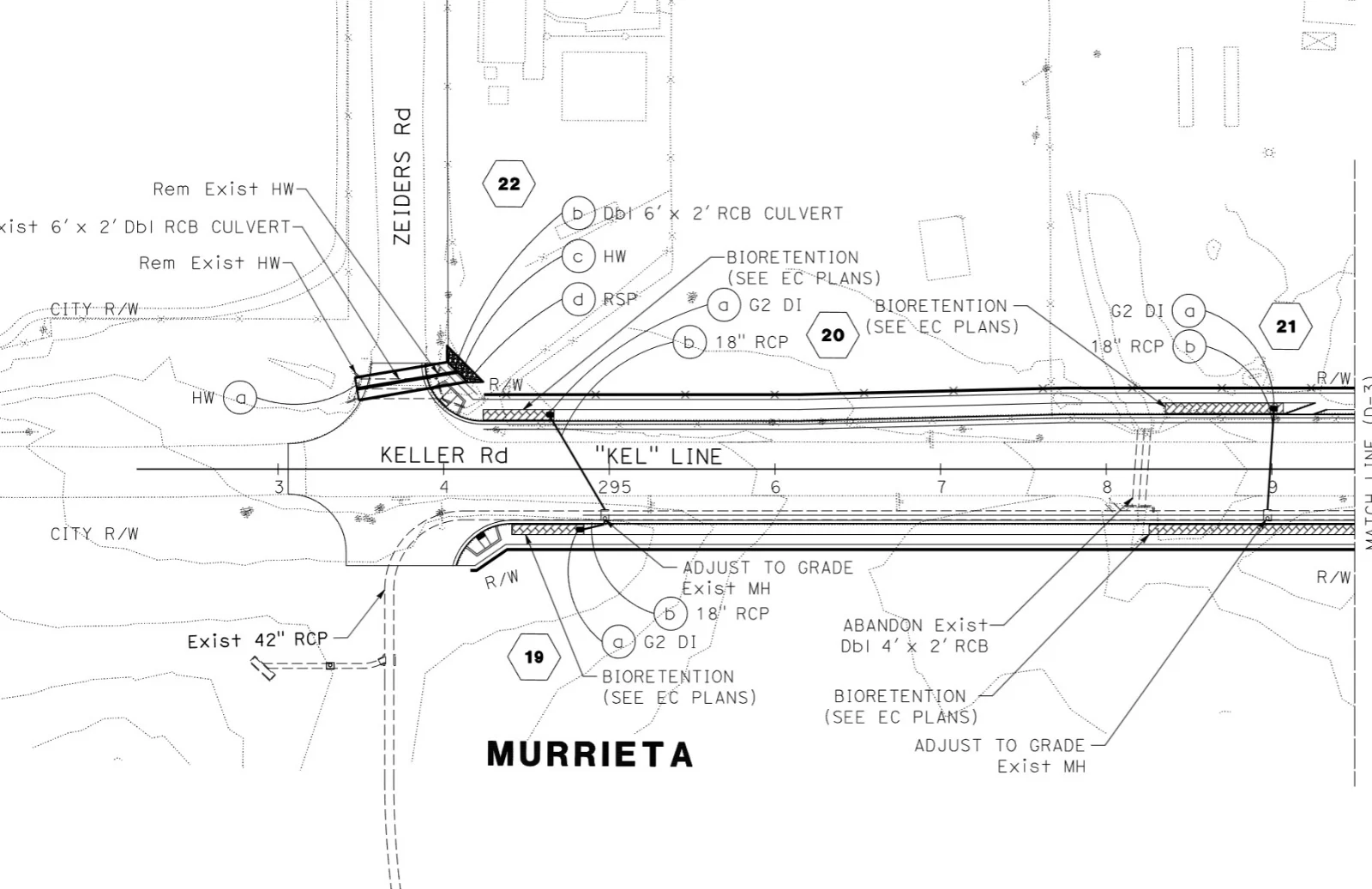

I-215 / Keller Interchange drainage sheet D-7 at the Zeiders Road double box culvert crossing
CRIQ candidate issueHigh
Temporary conveyance at Zeiders Road culvert replacement is unclear
Sheet
D-7 · source PDF p. 82
Discipline
Hydraulics / Drainage
Status
Open · awaiting your team’s response

Observation. D-7 removes the existing double 6 ft × 2 ft RCB culvert at Zeiders Road and builds a new one at the same crossing. No temporary flow route is shown for the interval in between.

Why it matters. Without a coordinated diversion, runoff could flood the work area or roadway and delay construction.

Next check. Compare staging and temporary drainage sheets with the existing flow path; confirm the excavation, diversion and reconnection sequence.

A real candidate issue from the CRIQ review of the I-215 / Keller Interchange 95% plans, clouded on its sheet as it reaches your team.

By the numbers One real review: I-215 / Keller Interchange, 95% PS&E plans

281plan-set pages reviewed in one I-215 / Keller Interchange 95% PS&E run
1,212 → 474raw candidates narrowed to retained findings by manager and Red Team review
21AI specialists: 12 plan-set disciplines and 9 environmental resource areas
100%of released findings signed off by an accountable human reviewer

The difference

Same course. A very different round.

Traditional review often finds the hazards once you are already in them. CivilRisk IQ shows you where they are before you swing, so your team can choose the next move with confidence.

An illustrative analogy.

How it works

From project records to a decision, in four steps.

  1. 01

    Define the record

    Agree on the plans, reports, studies and versions in scope. No project files are needed for the first conversation.

  2. 02

    Specialist AI review

    Discipline specialists read every sheet and page in parallel; a manager and a Red Team cull duplicates and weak claims.

  3. 03

    Human judgment

    A licensed engineer (design) or an authorized decision-maker (environmental) checks the evidence and decides what is released.

  4. 04

    Decision-ready outputs

    Executive summary, findings register, and PDF comment files for Bluebeam or Acrobat, plus optional portal access.

See the full review workflow →

What we review

If it's part of the project record, we can review it.

State highway projects or local capital improvements, early studies or final bid packages: the same specialist team and the same evidence-first method.

Plans & PS&E

Any milestone from 30% to 100%, any discipline: roadway, drainage, structures, traffic, utilities, staging and more.

Environmental documents & technical studies

EIR, EIS, EA, IS/MND and every study inside them: biology, cultural, noise, air quality, water quality, hazardous materials, visual, traffic.

Design technical reports

The reports behind the plans: geotechnical, soils and materials, foundation, structures, hydrology and drainage, traffic and utility reports.

Caltrans submittals

PSRs, project reports, PA&ED and PS&E packages, design standard decision documents, storm water data reports: check them as part of a thorough QA process.

Local capital improvement projects

City and county work off the State Highway System: pavement rehab, curb and gutter, sidewalks and ADA ramps, storm drains, signals.

Specs, estimates & schedules

Special provisions, quantities, engineer's estimates and construction schedules, checked against the plans they support.

Don't see your document?

A real finding, step by step

I-215 / Keller Interchange: Bioswale 45.

How to read our examples: these are real candidates from CRIQ reviews of actual plan sets. Each shows its status; a candidate is a question for the design engineer, not a verified defect or a statement about current field conditions.

I-215 / Keller Interchange · Bioswale 45 drainage profileStatus: engineer verification

Three flow-line elevations define the question.

D-3 / Upstream

I 308+07.99

FL 1568.55 ft

Bioswale 45 beginning
D-5 / Low point

I 311+90.3

FL 1566.96 ft

Intermediate grade
D-5 / End

I 313+00.85

FL 1567.73 ft

End grade

The last roughly 110 feet rises 0.77 feet.

D-5 annotations

I 311+90.3: FL 1566.96

I 313+00.85: FL 1567.73

End elevation is 0.77 ft above the intermediate low point.

Hydraulics & drainage specialist

Where does flow leave the low point?

No collection point was identified in the compared sheets. A rising grade alone does not establish a drainage defect.

Source-plan and drainage-design check needed

Verify the annotations and the intended outlet.

Evidence to check

D-3 and D-5 profile labels

Confirm stationing, flow-line elevations and the plotted grade on the source sheets and adjacent drainage details.

Still open

Low-point drainage path

Is there an inlet, underdrain, cross-sheet connection or intentional reverse flow?

Engineer decides whether the concern holds

A specific, bounded question for the drainage designer.

Findings-register entry

I-215 / Keller · Bioswale 45 · D-3 and D-5

Record
FL 1566.96 at I 311+90.3; FL 1567.73 at I 313+00.85.
Status
Pending engineer verification against the source plans.
Next action
Confirm the low-point collection feature or intended flow path with the drainage designer; document the answer on the plans.
A measured plan question. A traceable design response.

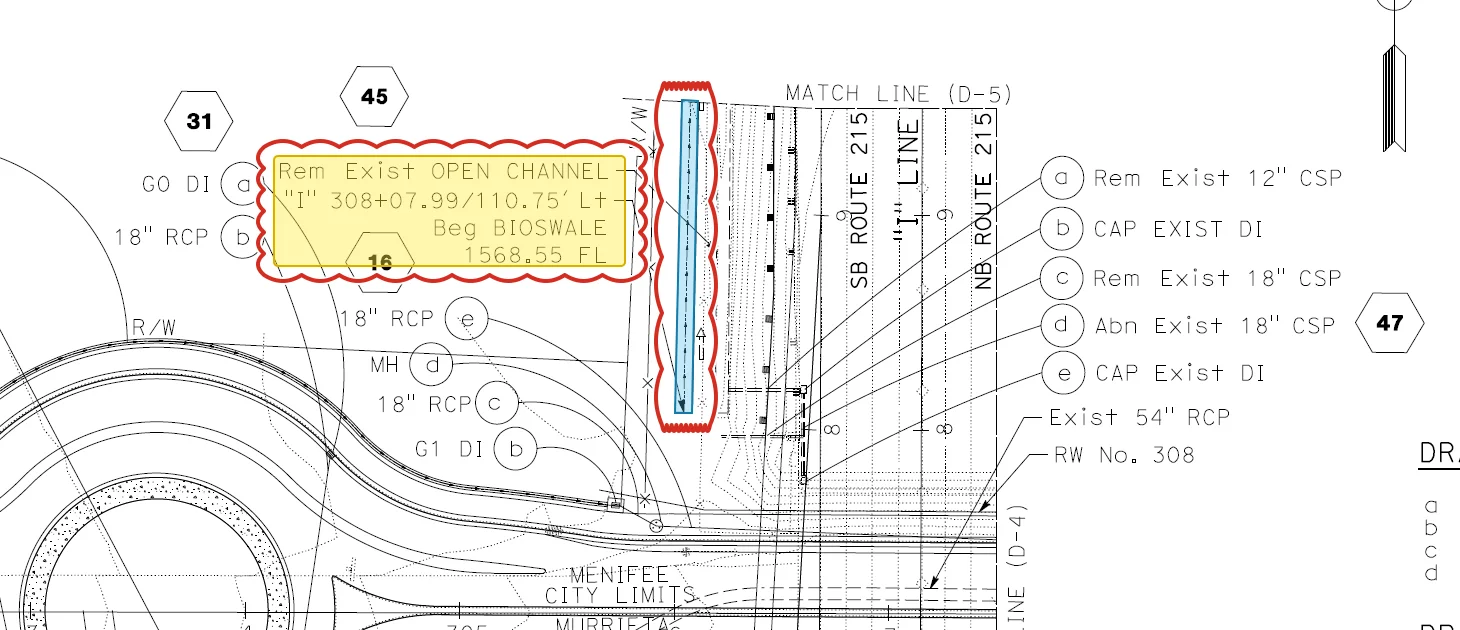

I-215 / Keller Interchange sheet D-3 excerpt: Bioswale 45 shaded blue with its beginning flow-line callout highlighted yellow and review clouds
Sheet D-3 · BeginningFL 1568.55 ft at I 308+07.99 · Open full size ↗

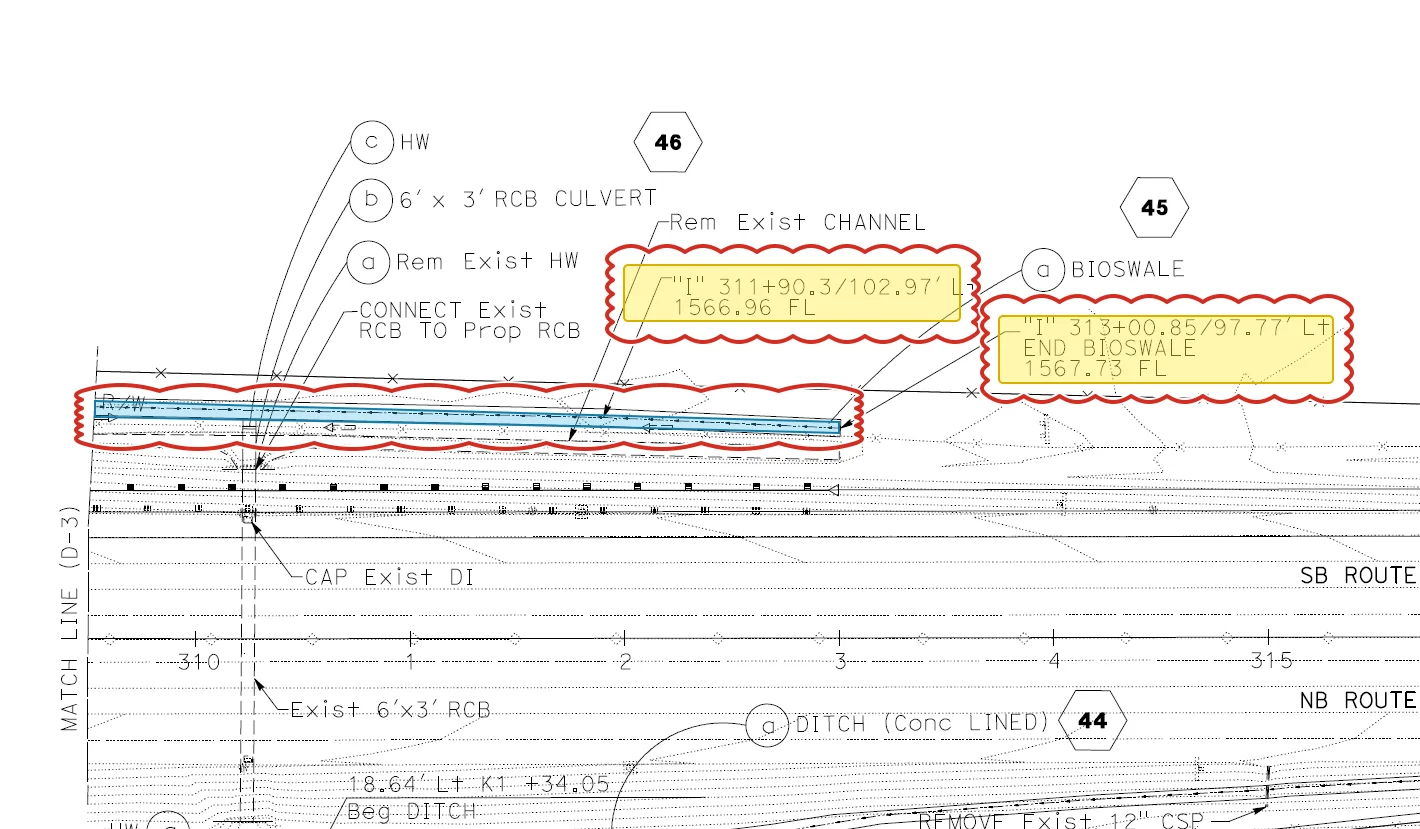

I-215 / Keller Interchange sheet D-5 excerpt: Bioswale 45 shaded blue around the dashed flow line, two flow-line callouts highlighted yellow and review clouds
Sheet D-5 · Low point and endFL 1566.96 ft to 1567.73 ft · Open full size ↗

Two more candidates from real plan sets

Glen Helen Parkway · west bridge approach

Check the temporary barrier gap

Sheet TH-02 ends a Type K railing run at Sta. 19+02.11; TH-01 begins one at 19+58.82 at nearly the same offset. If both apply to the same stage, the ~57 ft gap needs protection.

Candidate · traffic handling
I-215 / Keller · Retaining walls 307–308

Clear the ground-anchor path

Anchor rows with 20 ft unbonded lengths sit near existing piles and widening footings; 3-D drilling clearance isn't shown on the plans (source PDF p. 259).

Candidate · structures
